1967

SHELBY  RESEARCH  GROUP

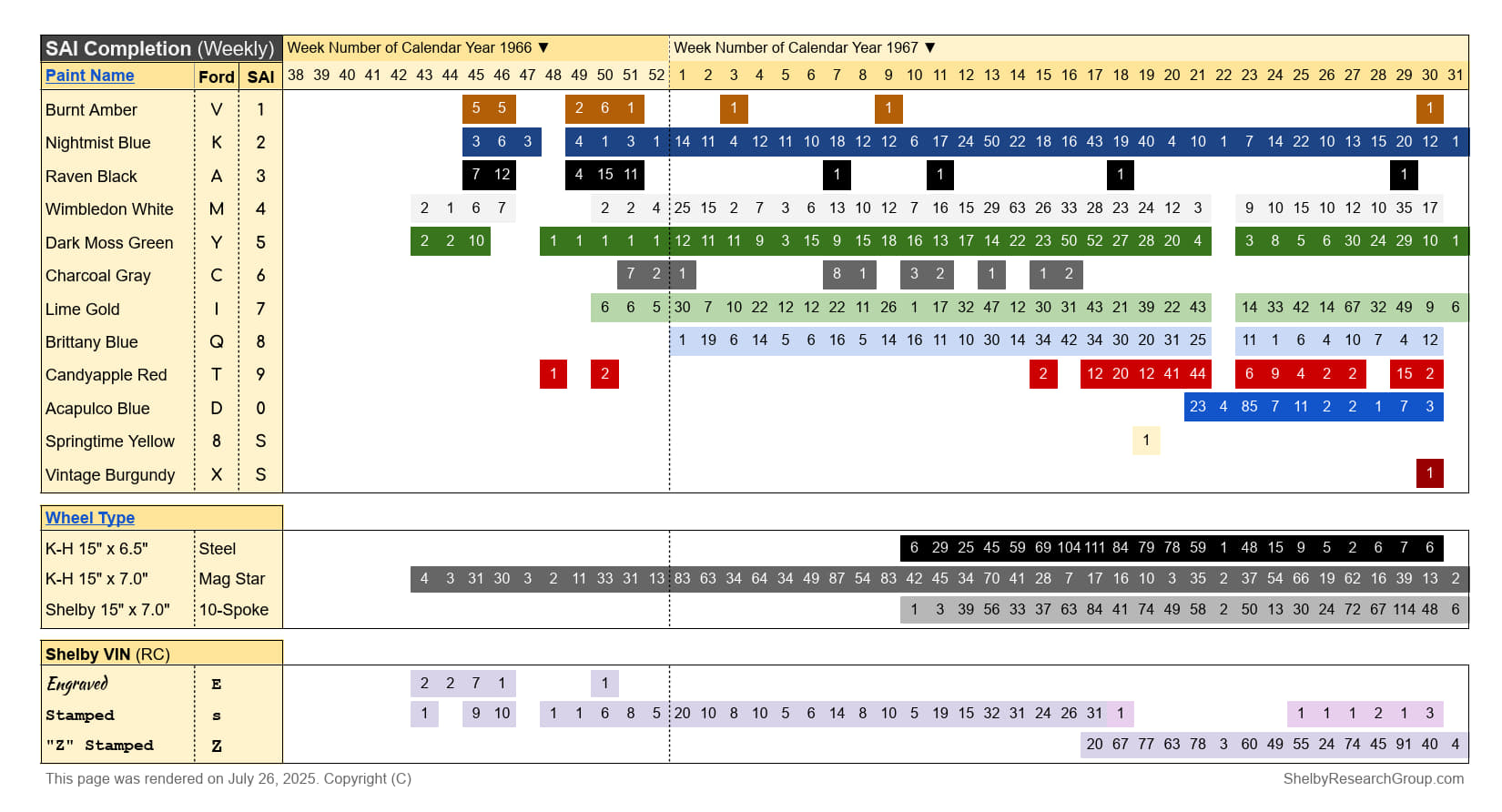

Production Gantt Chart (Shelby LAX)

  print pdf view data



1967 Shelby GT 350 and GT 500 'road car' production took place in the west hanger at 6501 Imperial Drive in Los Angeles, California.

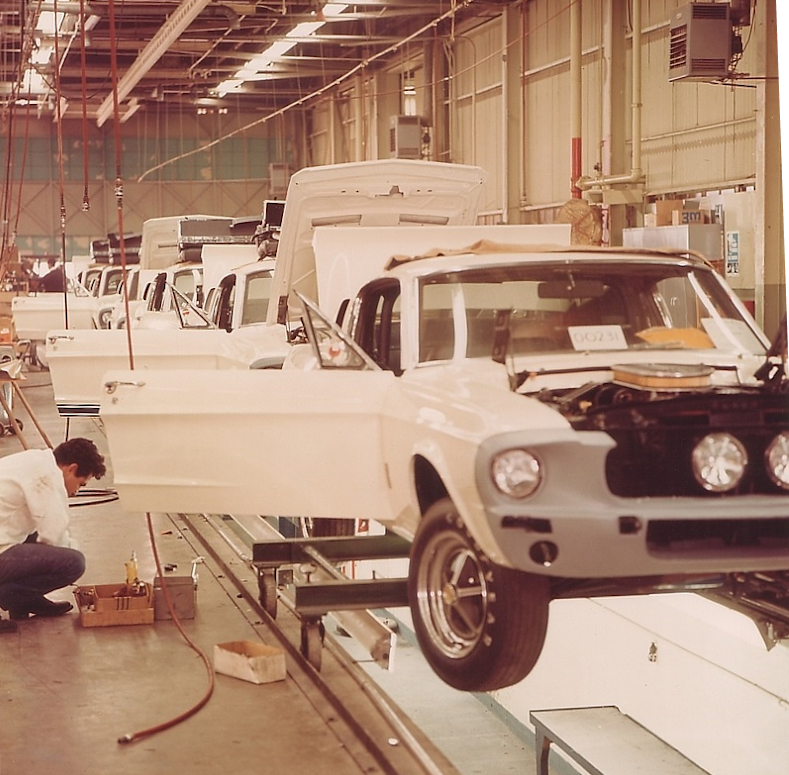

1967 Shelby GT production at Los Angeles airport.

1967 Shelby GT 350 #0231 (67200F4A00231) being fitted with its 'Shelby Upgrades' at Shelby American's west hanger at the the Los Angeles airport.

The first 'regular production' cars were completed by Shelby American on October 19, 1966. Only two (2) cars were recorded as completed on that first day: dark green GT 350 #0003 (67200F-50003) and white GT 350 #0018 (67200F-40018). These cars were promptly shipped off to Ford in Dearborn for public relations purposes and never returned to California.

#0003 was used for a PR Photo with Carroll, displayed at the Detroit International Auto Show, and was filmed for the first scene of the Shelby TV commercial with Carroll and Donald Fry outside the main entrance of Ford's North American Automotive Operations (NAAO) building.

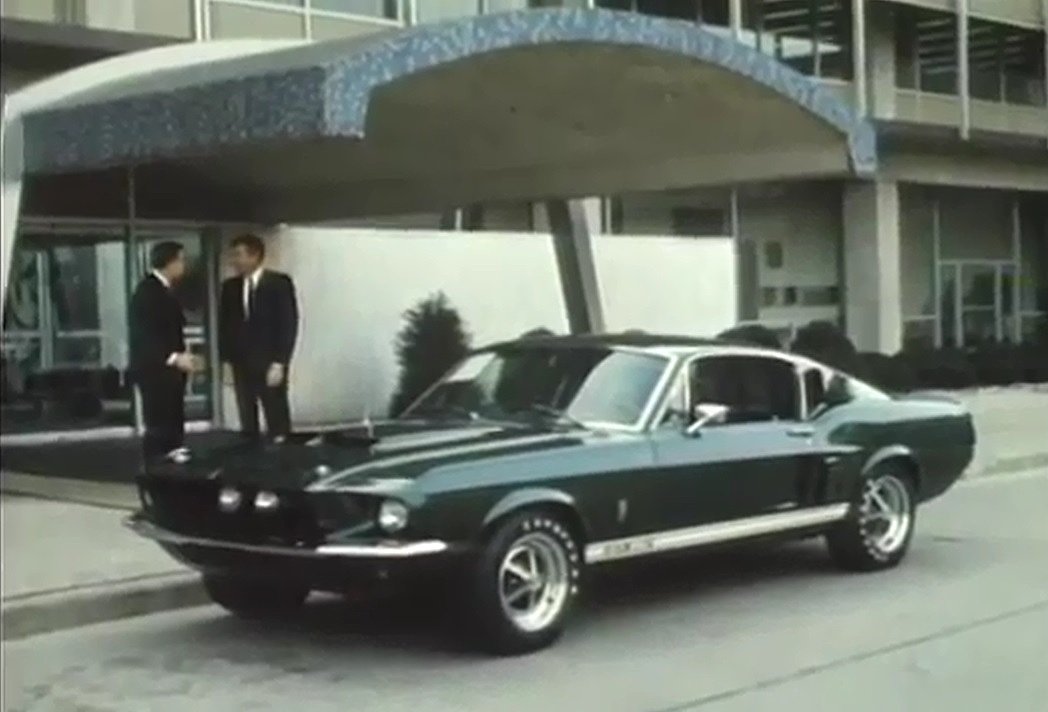

1967 Shelby GT350 #0003 outside Ford NAAO building

1967 Shelby GT 350 #00003 (67200F-5A0003) outside Ford's former NAAO building in Dearborn with Donald Frey and Carroll Shelby.



0018 was forwarded on to Ford's Canada headquarters in Oakville, Ontario. Photos of #0018 in the parking garage at Ford's Canada HQ have been found in the January 1967 Canada Track & Traffic magazine.

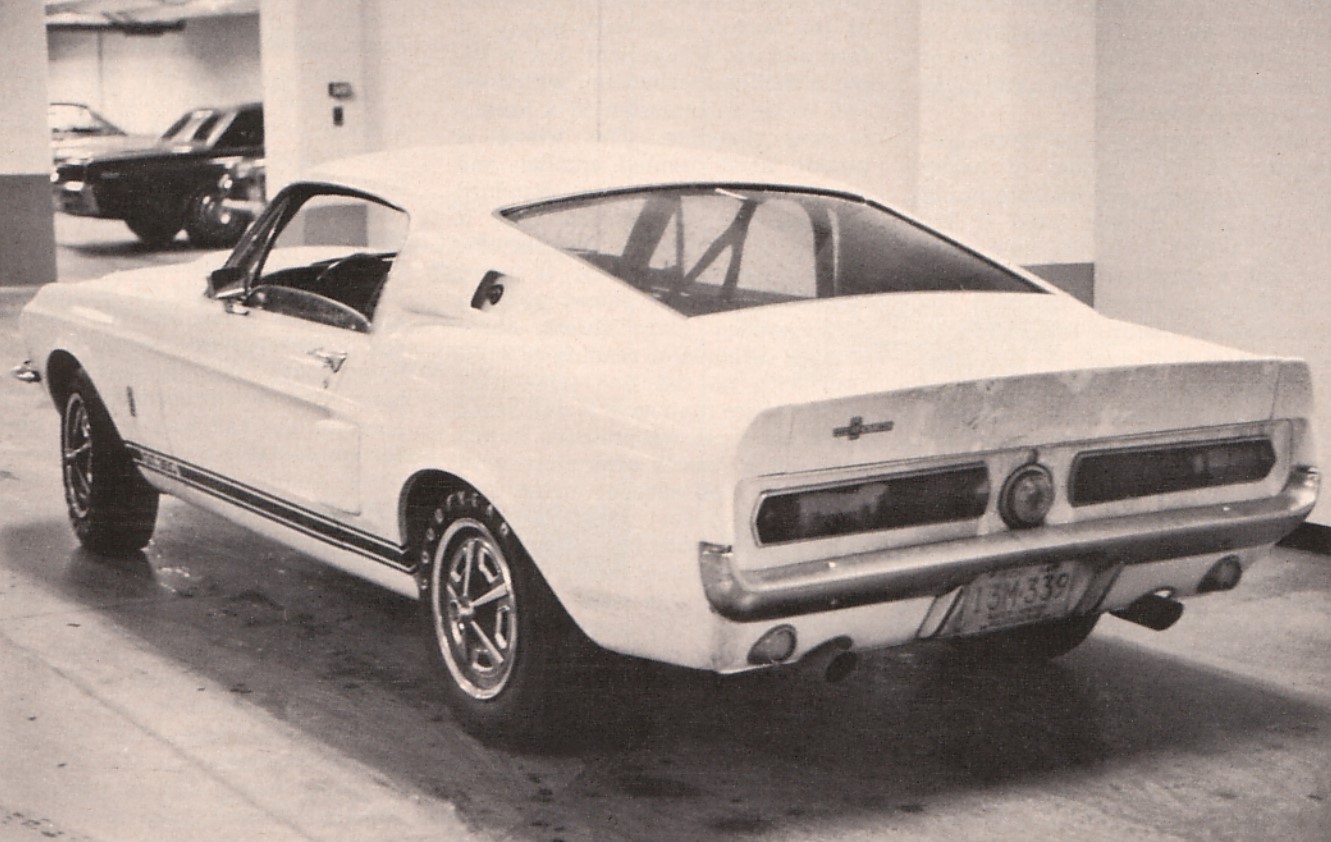

1967 Shelby GT350 #0018 in in the parking garage at Ford of Canada's HQ

1967 Shelby GT 350 #0018 (67200F-40018) in the parking garage at Ford of Canada headquarters in Oakville, Ontario.
